How long does it take to build a clean room?

Jason Peng, an engineer at Deiiang Company

  • Author:Jason Peng

  • Cleanroom Engineering Technology Manager of Deiiang Company.

    Product R&D Manager of GDC Inc. Cleanroom Equipment Manufacturing Company.

    Executive Director of Guangdong Cleanroom Industry Association of China.

  • 2024-11-06  |  Visits:

The construction time of a clean room is affected by many factors, including area, structure type, international logistICs, and the construction period of sub-projects. These factors will be analyzed in detail below.


Relationship with area

The area of the clean room directly affects the construction time. Generally speaking, the larger the area, the longer the construction time required. Taking a 100 square meter clean room as an example, the construction time may be between 3-6 months, while a 500 square meter modular clean room may take 6-12 months. The increase in area not only increases the use of materials, but also requires more manpower and time for construction.

  • 100 square meters: 3-6 months

  • 500 square meters: 6-12 months

Related to the type of clean room structure

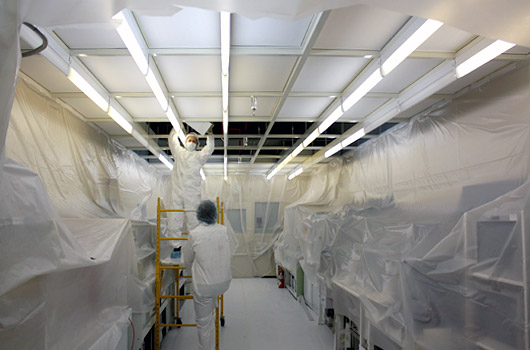

Different types of clean room structures will affect the construction time.cleanroom_const20_1_large-1.jpg

1. hard wall clean room

hard wall clean rooms usually use concrete or metal materials, and the construction period is longer, usually 3-6 months, because their structure is stable and requires high construction precision.

2. Soft-wall cleanroom

Soft-wall cleanrooms use lightweight materials and are relatively simple to construct, usually taking 2-4 months, suitable for quick construction and disassembly.

3. modular cleanroom

modular cleanrooms use prefabricated modules, with the shortest construction time, usually completed within 1-3 months, suitable for rapid response to market demand.

  • Hard wall: 3-6 months

  • Soft wall: 2-4 months

  • Modular: 1-3 months

International logistICs

The efficiency of international logistics directly affects the material supply for modular cleanroom construction. If the materials are imported from abroad, it usually takes 1-2 months for transportation and customs clearance. Logistics delays may lead to delays in the overall construction progress, so choosing a local supplier can effectively shorten the construction time.

Construction period of sub-projects

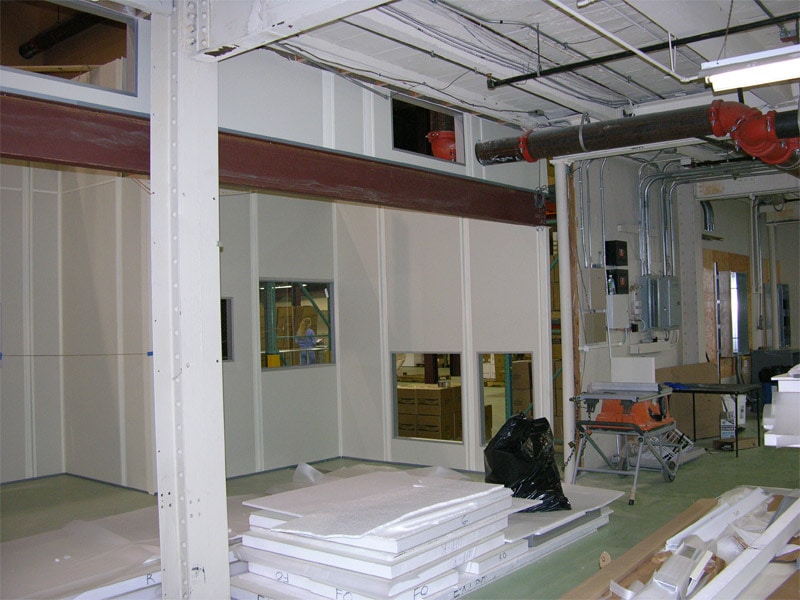

The construction time of eACH sub-project should also be considered:Cleanroom-Construction2.jpg

1. Wall partition ceiling

generally 1 month, 2-3 months for large areas.

2. Ventilation duct project

generally 1 month, 2-3 months for large areas.

3. Purification air conditioning unit

production cycle is about 30 days.

4. Ground construction

20-30 days.

5. Equipment installation and commissioning

10-20 days.

-  of sub-projects:

  • Wall partition: 1-3 months

  • Ventilation duct: 1-3 months

  • Purification air conditioning unit: 30 days

  • Ground construction: 20-30 days

  • Equipment installation and commissioning: 10-20 days


the time to build a clean room varies depending on many factors, usually between 3 and 12 months. Choosing the right structure Type And material supplier, and arranging the construction period reasonably can effectively shorten the construction time.
