There is no universal duration for a modular cleanroom project. Total completion depends on design and approvals, design freeze, manufacturing, site readiness, shipping, installation, system integration, commissioning, classification testing and qualification where applicable. Stages may overlap. The critical path controls completion. A reliable answer requires agreed start and end milestones, not a single number.

What Does a Modular Cleanroom Project Timeline Include?

Modular cleanroom configuration diagram
A modular cleanroom configuration diagram illustrating typical project scope elements.

Lead time can mean different endpoints. The project start may be contract signature, deposit, complete data, drawing approval or another agreed trigger. The end may be installation, commissioning, classification, qualification or release for intended use, depending on the project. Align scope and end milestone before comparing durations.

Supplier lead time versus total project completion

A supplier’s quoted lead time covers what its contract scope includes. Depending on the agreement, this may include any combination of engineering, procurement, manufacturing, factory acceptance testing, packing and shipping preparation. It is not always only a subset of total project completion, because the supplier’s endpoint may be factory release, delivery or installation.

Total project completion includes owner decisions, site preparation, installation, integration, commissioning, classification testing and qualification where applicable. Compare supplier quotes only after the start trigger, scope and end milestone match.

Manufacturing, delivery and installation are different milestones

Cleanroom manufacturing lead time

This covers fabrication and/or procurement of components within the supplier’s contract scope. It may include panels, ceilings, doors, glazing, filters, fan filter units, controls, air handling units and other equipment. Some items may be purchased rather than fabricated. Release for eACH package depends on approved specifications and release information.

Modular cleanroom delivery time

Delivery includes packing, transport, customs and import where applicable, inland delivery and unloading. Incoterms® rules and the named place allocate seller and buyer obligations, costs and risk. They do not guarantee transit time. Customs, unloading and site handling responsibilities should be stated separately, because an Incoterm alone may not cover them.

Modular cleanroom installation time

Installation covers assembly and connection of the delivered scope. Physical installation of a package follows that package’s delivery. Site work, phased logistics and later deliveries may run in parallel. Installation completion is not the same as a commissioned or classified cleanroom.

Commissioned, classified and qualified are different endpoints

Commissioning verifies that installed systems function according to agreed project criteria. It may include airflow, pressure, controls, alarms and utility checks, depending on scope. ISO particle classification is a separate test of airborne particle concentrations against a specified iso class and state, following iso 14644-1:2015. It is not a complete operational release.

Supporting tests, such as filter integrity, airflow, pressure and temperature/relative humidity, apply only where project specifications require them, with methods such as iso 14644-3:2019 where applicable. Qualification applies only where a quality or regulatory framework requires it. Its sequence relative to classification depends on that framework. There is no universal qualification model.

iso 14644-4:2022 supports the process from requirements through design, construction and start-up. It does not define particle classification, FAT, SAT or qualification details.

Project stage dependencies and overlap table

StageMain activityKey dependencyCan overlap?Evidence/milestone
RequirementsDefine use case, ISO class where applicable, flows, utilities, acceptance criteriaOwner input, process dataYes; concept design can iterate with requirementsUser requirements where applicable
DesignLayout, HVAC, utilities, controls, interfacesRequirements, site dataYes; design packages can progress at different ratesIssued design documents
ApprovalInternal review, permits where applicableDesign, AHJ availabilityLimited; can overlap with later design packagesApproved review record; permit or AHJ approval where applicable
Design freezeLock dimensions, interfaces, utilities, acceptance criteriaApprovals, owner sign-offUsually gates fabrication release; controlled long-lead procurement may proceed earlierFrozen design record
ProcurementOrder long-lead itemsApproved specification and release information for the specific itemYes; package-by-package release can precede full project freezePurchase orders
ManufacturingFabricate enclosure components and manufacture/procure supplier-scope equipmentFrozen design or approved package release, materialsYes; packages can be released progressivelyFactory release per package
Site preparationFloor, structure, utilities, accessDesign freeze for relevant packages, building conditionsYes; logistics booking and documentation can run in parallel with manufacturingSite readiness checklist
ShippingPack, transport, customs, deliveryFactory release of the relevant package, Incoterm and named placeYes; booking and documents can precede physical shipmentDelivery receipt
InstallationEnclosure, HVAC, utilities, sealsSite ready, relevant package deliveredYes; phased delivery can allow staged installationInstallation complete per package
IntegrationConnect controls, sensors, BMS, utilitiesInstallation of ready packages, real utilitiesYes; integration can proceed package by packageIntegration test records
CommissioningVerify systems against agreed criteriaIntegration of relevant systemsCan overlap with early testing of completed packagesCommissioning report
ISO classificationParticle classification against specified ISO class and stateStable commissioned conditions, agreed test planSeparate from supporting tests; sequence depends on project planClassification report
Supporting/acceptance testsFilter integrity, airflow, pressure, temperature/RH where specifiedCommissioning, agreed test methodsMay overlap with commissioning where conditions allowTest reports
QualificationDocumentation, calibration, deviations, corrective actionsDefined plan and prerequisitesOverlap depends on applicable frameworkQualification approval where applicable
HandoverAs-builts, O&M, training, punch list closeAll applicable prior stagesMay be final or phased depending on contractHandover certificate
Requirements

Activity: Define use case, ISO class where applicable, flows, utilities, acceptance criteria.

Dependency: Owner input, process data.

Overlap: Yes; concept design can iterate with requirements.

Evidence/milestone: User requirements where applicable.

Design

Activity: Layout, HVAC, utilities, controls, interfaces.

Dependency: Requirements, site data.

Overlap: Yes; design packages can progress at different rates.

Evidence/milestone: Issued design documents.

Approval

Activity: Internal review, permits where applicable.

Dependency: Design, AHJ availability.

Overlap: Limited; can overlap with later design packages.

Evidence/milestone: Approved review record; permit or AHJ approval where applicable.

Design freeze

Activity: Lock dimensions, interfaces, utilities, acceptance criteria.

Dependency: Approvals, owner sign-off.

Overlap: Usually gates fabrication release; controlled long-lead procurement may proceed earlier.

Evidence/milestone: Frozen design record.

Procurement

Activity: Order long-lead items.

Dependency: Approved specification and release information for the specific item.

Overlap: Yes; package-by-package release can precede full project freeze.

Evidence/milestone: Purchase orders.

Manufacturing

Activity: Fabricate enclosure components and manufacture/procure supplier-scope equipment.

Dependency: Frozen design or approved package release, materials.

Overlap: Yes; packages can be released progressively.

Evidence/milestone: Factory release per package.

Site preparation

Activity: Floor, structure, utilities, access.

Dependency: Design freeze for relevant packages, building conditions.

Overlap: Yes; logistics booking and documentation can run in parallel with manufacturing.

Evidence/milestone: Site readiness checklist.

Shipping

Activity: Pack, transport, customs, delivery.

Dependency: Factory release of the relevant package, Incoterm and named place.

Overlap: Yes; booking and documents can precede physical shipment.

Evidence/milestone: Delivery receipt.

Installation

Activity: Enclosure, HVAC, utilities, seals.

Dependency: Site ready, relevant package delivered.

Overlap: Yes; phased delivery can allow staged installation.

Evidence/milestone: Installation complete per package.

Integration

Activity: Connect controls, sensors, BMS, utilities.

Dependency: Installation of ready packages, real utilities.

Overlap: Yes; integration can proceed package by package.

Evidence/milestone: Integration test records.

Commissioning

Activity: Verify systems against agreed criteria.

Dependency: Integration of relevant systems.

Overlap: Can overlap with early testing of completed packages.

Evidence/milestone: Commissioning report.

ISO classification

Activity: Particle classification against specified ISO class and state.

Dependency: Stable commissioned conditions, agreed test plan.

Overlap: Separate from supporting tests; sequence depends on project plan.

Evidence/milestone: Classification report.

Supporting/acceptance tests

Activity: Filter integrity, airflow, pressure, temperature/RH where specified.

Dependency: Commissioning, agreed test methods.

Overlap: May overlap with commissioning where conditions allow.

Evidence/milestone: Test reports.

Qualification

Activity: Documentation, calibration, deviations, corrective actions.

Dependency: Defined plan and prerequisites.

Overlap: Overlap depends on applicable framework.

Evidence/milestone: Qualification approval where applicable.

Handover

Activity: As-builts, O&M, training, punch list close.

Dependency: All applicable prior stages.

Overlap: May be final or phased depending on contract.

Evidence/milestone: Handover certificate.

Static four-step scheduling frame: define the start and end milestone; map dependencies; identify parallel work; identify the critical path and owner holds. Do not use a formulaic week count or automatic duration calculator.

How Design Freeze, Manufacturing and Parallel Site Work Affect Lead Time

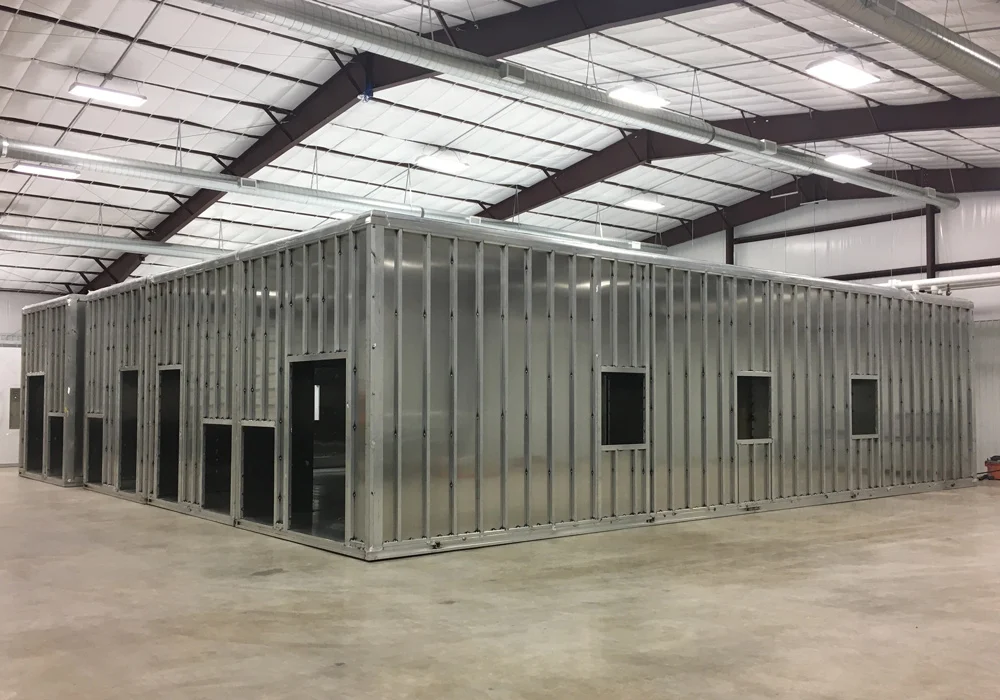

Prefabricated modular cleanroom frame under construction in a factory
A prefabricated modular cleanroom frame in a factory setting, shown for illustration only.

Many downstream risks are easier to address before design freeze. After freeze, changes ripple through procurement, fabrication and site work.

Requirements and approvals before design freeze

Before freeze, the owner and design team should align on layout and dimensions, equipment and interfaces, HVAC strategy, utilities, controls and monitoring, penetrations and openings, and acceptance criteria. Owner engineering, QA, validation, EHS and procurement should review as applicable. Permits and AHJ approvals apply where required.

Unresolved requirements can create later delay, but the effect depends on the project. If the ISO class, equipment list, utility capacities or acceptance criteria are not settled, the design cannot freeze confidently, and procurement may be held for affected packages.

Design freeze as a schedule gate

Design freeze is a milestone where dimensions, interfaces and utilities are locked for manufacturing and site work. It is not a duration. Late changes after freeze can trigger redraws, new procurement, refabrication, HVAC or utility changes, and additional reviews.

A change to a wall panel dimension may be manageable. A change to HVAC capacity, pressure cascades or utility routing may affect multiple disciplines and long-lead equipment. Packages with approved release information may still proceed to manufacturing before full project freeze.

Cleanroom manufacturing lead time and long-lead items

Manufacturing covers the supplier’s contract scope. It may include fabrication of enclosure components and manufacture or procurement of filters, fan filter units, controls, air handling units and other equipment. Some items may be project-specific long-lead items. The supplier should identify them and explain what starts their clock.

Manufacturing can be released package by package. This is not the same as a partial freeze without controls. Each package needs approved specifications and release information sufficient for production or purchase.

Parallel factory fabrication and site preparation

Factory fabrication and site preparation can overlap when dimensions, connections, loads and utility assumptions are stable for the relevant packages. Site work may include floor and building preparation, structure, utility rough-ins, HVAC and services routing, and access arrangements.

The NIH ORF publication discusses modular construction in a research-facility context and notes it may reduce onsite construction and that pre-planning is important. It is not a general industry standard. The Deiiang company-published pharmaceutical planning information links a 3–6 month timeline partly to parallel site preparation and factory fabrication. That is company-published planning information, not independent industry data, not an industry average, not a guarantee and not a contractual commitment. Conditions can change the timing.

Shipping, Installation and the Cleanroom Commissioning Timeline

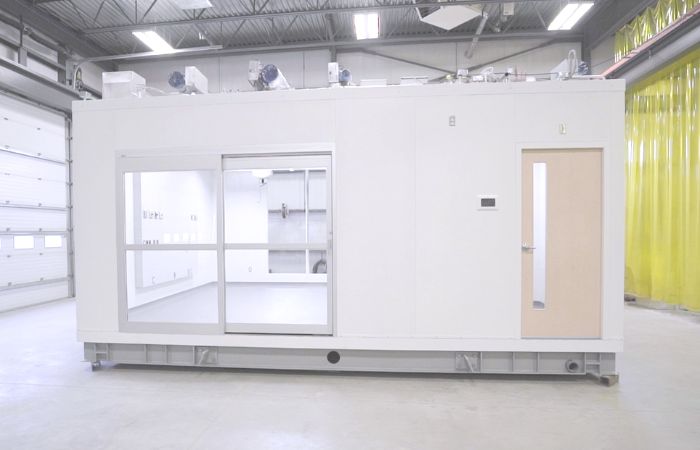

Cleanroom wall panel installation on site
On-site installation of cleanroom wall panels.

Shipping and installation are sequential from the release of each package, but site preparation and later deliveries can run in parallel.

Modular cleanroom shipping time and responsibilities

Shipping includes factory release, packing, transport, customs and import where applicable, inland delivery and unloading. The Incoterms® rule and named place allocate seller and buyer obligations, costs and risk. They do not guarantee transit time. Customs, unloading and site handling responsibilities should be confirmed separately.

Customs and import can add variability outside normal manufacturing control. The schedule should identify who manages customs documentation and what happens if clearance is delayed.

Site readiness checklist before installation

  • Floor and site area prepared to required tolerance
  • Access route clear for modules and equipment
  • Utilities available or roughed in to agreed points
  • Storage area for components if needed
  • Other trades coordinated for sequencing to avoid construction conflicts and contamination risk
  • Work-hour restrictions understood

Other trades do not necessarily need to leave the area completely. Sequencing should be planned to avoid conflicts and contamination risk.

Modular cleanroom installation time

Installation includes the enclosure (walls, ceilings, doors, glazing, seals and penetrations), HVAC and filtration (fan filter units, filters, ducts, returns and exhaust as applicable), and utilities and controls (power, sensors, BMS, data and process connections). Physical installation follows each package’s delivery. Installation and integration may overlap as interfaces become ready.

For factory-built modular unit systems, the NIH ORF publication notes tight clearance and module movement into buildings as considerations. For panelized systems, early coordination of wall depth, utilities and access is appropriate. Those NIH observations apply to the factory-built modular unit systems discussed there, not to all panelized cleanrooms.

Integration and commissioning

Integration connects installed systems to real utilities and controls. Commissioning brings systems to the defined conditions required by specified acceptance tests. It may include balancing, pressure relationships, controls, sensors, specified alarms and interlocks, and utility checks.

FAT and SAT

Factory acceptance testing applies only to functions that can be realistically tested at the factory. Site acceptance testing occurs at the site once real utilities and interfaces exist. FAT does not eliminate SAT.

For the factory-built modular unit systems discussed by NIH ORF, factory utility limitations can mean more site adjustment and balancing, and deficiencies found at SAT may affect schedule. That observation is limited to the NIH discussion context.

Testing, Qualification, Critical Path and Delay Risks

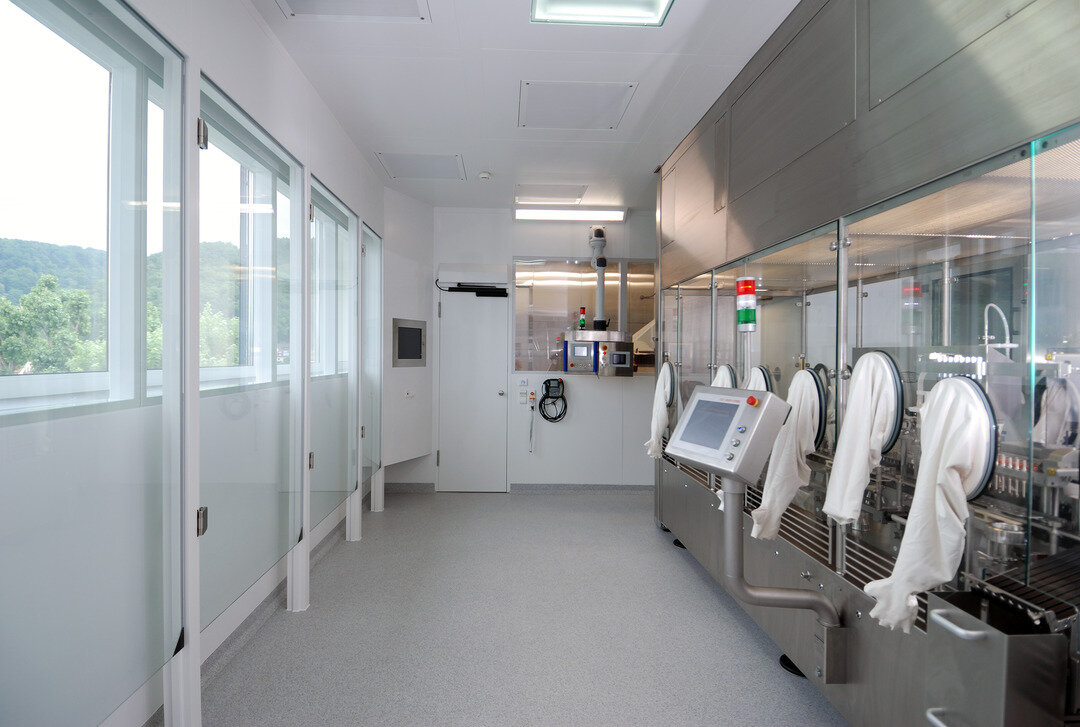

Cleanroom personnel and monitoring scene
Cleanroom personnel and monitoring activity during the testing phase.

ISO classification testing

Where an ISO class is specified, classification verifies particle concentrations under defined conditions in accordance with iso 14644-1:2015. Test methods may follow iso 14644-3:2019 where applicable. The required class and state, test conditions, responsible tester and acceptance documents should be agreed in advance. Classification is not a complete operational release.

Supporting tests, such as filter integrity, airflow, pressure and temperature/relative humidity, apply only when specified. They are separate from particle classification and should be listed with their acceptance criteria.

Qualification is separate from classification

Qualification applies only where a quality or regulatory framework requires it. It depends on a defined plan and prerequisites, which may include approved documents, calibration, commissioning records, reports, deviations and corrective actions. Its sequence relative to classification depends on the applicable framework. There is no universal qualification model and no generic IQ/OQ/PQ duration.

Critical path and dependency-based scheduling

A dependency-based schedule should show the activities that control completion. When formal critical path method scheduling is used, list the critical path and float. A short schedule review should confirm:

  • Start and end milestone for each activity
  • Predecessor and dependency
  • Owner hold or approval
  • Float and contingency assumption

The critical path can change as stages complete or delays occur.

Delay sources

  • Incomplete requirements
  • Delayed approval or freeze, or unresolved decisions
  • Post-freeze changes
  • Long-lead components
  • Incomplete site
  • Utility or interface issues
  • Shipping or customs delays
  • FAT or SAT problems
  • Commissioning deficiencies
  • Failed acceptance tests
  • Missing qualification or handover documents

Can a modular cleanroom project take 3–6 months?

Deiiang company-published pharmaceutical planning information links a 3–6 month timeline partly to parallel factory fabrication and site preparation. This is company-published planning information, not independent industry data, not an industry average, not a guarantee and not a contractual commitment. Actual timing depends on scope, customization, approvals, design freeze, availability, site conditions, logistics, integration, testing and qualification.

One separate company-published example is the Hubei Chunhui Class 100 clean booth case. Its published on-site sequence is a 40-day construction plan: days 1–10 frame and ffu hangers; days 11–20 enclosure panels and floor; days 21–30 HVAC, air shower, pass box and sensors; days 31–35 integration and filter balancing; days 36–40 third-party static and dynamic tests. This is one company-published clean-booth on-site plan, not a full project lead time, not the basis for the 3–6 month statement and not extrapolatable to other scopes.

What Owners Should Prepare and Ask Before Accepting a Schedule

Cleanroom layout drawing
A cleanroom layout drawing used for owner planning discussions.

Owner preparation can be organized into four cards.

Process and performance

Process and use case; contamination objective; target ISO class and state if applicable; equipment and interfaces; occupancy and personnel flows; temperature and relative humidity; pressure/containment/product-protection objective where applicable.

Building and site

Building dimensions, clear height, site survey, structure, floor and access; fire, building and installation route constraints; target milestone; access and shutdown limits; permit and AHJ responsibility.

Utilities and interfaces

Power; available heating and cooling utilities where applicable; exhaust; gases; water; vacuum; drainage; BMS and data; utility points and capacities.

Acceptance and schedule

Commissioning, classification, tests and qualification scope where applicable; as-builts, O&M manuals and training; owner approval turnaround; acceptance criteria; schedule update expectations.

Supplier questions

  • What starts the quoted lead time: purchase order, deposit, complete data, drawing approval or design freeze?
  • What ends it: factory complete, shipment, delivery, installation, commissioning, classification or handover?
  • What are the buyer dependencies?
  • Which long-lead items have been identified?
  • What are the shipping assumptions, Incoterm, place, customs responsibility and unloading responsibility?
  • Are FAT, SAT, commissioning, classification, supporting tests and qualification support included?
  • Which dates are firm commitments, which are planning estimates, and which assumptions would trigger a schedule revision?
  • How often is the milestone schedule updated, and who owns the recovery plan if a critical activity slips?
  • What happens if criteria fail: corrective action, retesting and schedule update?

How to Compare Supplier Lead-Time Quotations

Cleanroom interior installation
Cleanroom interior installation work during project execution.
Schedule itemSupplier ASupplier BOwner dependencyEvidence/milestoneClarification required
Start milestone
End milestone
Requirements/design
Drawing approval
Design freeze
Long-lead procurement
Manufacturing
FAT where applicable
Site preparation
Shipping
Customs/import where applicable
Installation
HVAC/utilities integration
Balancing
Commissioning
SAT where applicable
ISO classification
Supporting tests
Qualification support where applicable
Handover
Critical-path/schedule assumption
Owner approval turnaround assumed
Exclusions/assumptions
Start milestone

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

End milestone

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Requirements/design

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Drawing approval

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Design freeze

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Long-lead procurement

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Manufacturing

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

FAT where applicable

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Site preparation

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Shipping

Supplier A:

Supplier B:

Owner dependency:

Evidence/milestone:

Clarification required:

Customs/import where applicable

Supplier A: Record the supplier's quoted milestone or duration for customs and import handling where applicable.

Supplier B: Record the supplier's quoted milestone or duration for customs and import handling where applicable.

Owner dependency: Record any owner-held documents, duties, broker instructions or approvals required.

Evidence/milestone: Record the agreed evidence, such as clearance confirmation or delivery receipt.

Clarification required: Record who handles customs, import duties and documentation.

Installation

Supplier A: Record the supplier's quoted milestone or duration for installation.

Supplier B: Record the supplier's quoted milestone or duration for installation.

Owner dependency: Record site readiness, access and utility availability required from the owner.

Evidence/milestone: Record the agreed evidence, such as installation completion per package.

Clarification required: Record what installation scope is included and what is excluded.

HVAC/utilities integration

Supplier A: Record the supplier's quoted milestone or duration for HVAC and utilities integration.

Supplier B: Record the supplier's quoted milestone or duration for HVAC and utilities integration.

Owner dependency: Record real utilities, interfaces and access required from the owner.

Evidence/milestone: Record the agreed evidence, such as integration test records.

Clarification required: Record interface responsibility boundaries between trades and suppliers.

Balancing

Supplier A: Record the supplier's quoted milestone or duration for balancing.

Supplier B: Record the supplier's quoted milestone or duration for balancing.

Owner dependency: Record any owner approvals or utility conditions required.

Evidence/milestone: Record the agreed evidence, such as a balancing report.

Clarification required: Record who performs balancing and what acceptance criteria apply.

Commissioning

Supplier A: Record the supplier's quoted milestone or duration for commissioning.

Supplier B: Record the supplier's quoted milestone or duration for commissioning.

Owner dependency: Record owner approvals, access and utility conditions required.

Evidence/milestone: Record the agreed evidence, such as a commissioning report.

Clarification required: Record the commissioning criteria and what is included in the supplier's scope.

SAT where applicable

Supplier A: Record the supplier's quoted milestone or duration for SAT where applicable.

Supplier B: Record the supplier's quoted milestone or duration for SAT where applicable.

Owner dependency: Record real utilities, interfaces and access required from the owner.

Evidence/milestone: Record the agreed evidence, such as SAT records.

Clarification required: Record whether SAT is included and what happens if criteria fail.

ISO classification

Supplier A: Record the supplier's quoted milestone or duration for ISO classification.

Supplier B: Record the supplier's quoted milestone or duration for ISO classification.

Owner dependency: Record any owner approvals, access or conditions required.

Evidence/milestone: Record the agreed evidence, such as a classification report per ISO 14644-1:2015.

Clarification required: Record the specified ISO class and state, responsible tester and acceptance documents.

Supporting tests

Supplier A: Record the supplier's quoted milestone or duration for supporting tests where specified.

Supplier B: Record the supplier's quoted milestone or duration for supporting tests where specified.

Owner dependency: Record any owner approvals, access or conditions required.

Evidence/milestone: Record the agreed evidence, such as test reports.

Clarification required: Record which supporting tests are specified and that they are separate from particle classification.

Qualification support where applicable

Supplier A: Record the supplier's quoted milestone or duration for qualification support where applicable.

Supplier B: Record the supplier's quoted milestone or duration for qualification support where applicable.

Owner dependency: Record the defined plan, prerequisites and approvals required from the owner.

Evidence/milestone: Record the agreed evidence, such as qualification approval where applicable.

Clarification required: Record responsibility boundaries and the applicable quality or regulatory framework.

Handover

Supplier A: Record the supplier's quoted milestone or duration for handover.

Supplier B: Record the supplier's quoted milestone or duration for handover.

Owner dependency: Record owner review, training attendance and punch list closeout required.

Evidence/milestone: Record the agreed evidence, such as a handover certificate.

Clarification required: Record whether handover is final or phased and what documents are included.

Critical-path/schedule assumption

Supplier A: Record the supplier's stated critical-path and schedule assumptions.

Supplier B: Record the supplier's stated critical-path and schedule assumptions.

Owner dependency: Record any owner holds or approvals that affect the critical path.

Evidence/milestone: Record the agreed evidence, such as a schedule update or recovery plan.

Clarification required: Record which activities control completion and how float is treated.

Owner approval turnaround assumed

Supplier A: Record the supplier's assumed owner approval turnaround.

Supplier B: Record the supplier's assumed owner approval turnaround.

Owner dependency: Record the actual owner approval process and expected turnaround.

Evidence/milestone: Record the agreed evidence, such as approved review records.

Clarification required: Record what happens if owner approvals take longer than assumed.

Exclusions/assumptions

Supplier A: Record the supplier's stated exclusions and assumptions.

Supplier B: Record the supplier's stated exclusions and assumptions.

Owner dependency: Record any owner-supplied scope or conditions.

Evidence/milestone: Record the agreed evidence, such as a signed scope clarification.

Clarification required: Record any assumption that would trigger a schedule revision.

Mobile comparison cards should show the same fields as the desktop table: schedule item, supplier milestone and duration, owner dependency, evidence/milestone and clarification required. Do not compare headline dates until the start milestone, scope and end milestone match. A static dependency or Gantt-style diagram, expandable mobile cards, or an RFQ checklist may be used instead of an automatic lead-time calculator.

FAQs

What is the typical lead time?

There is no universal duration. It depends on agreed start and end milestones, scope, design freeze, manufacturing, site readiness, shipping, installation, integration, commissioning, classification testing and qualification where applicable.

Which stages usually control the timeline?

Delayed approval or freeze, unresolved decisions, long-lead procurement, site readiness, shipping and customs, installation, integration, commissioning and qualification can control completion. The critical path depends on the project and can change.

Can site preparation and manufacturing happen together?

Yes, when dimensions, connections, loads and utility assumptions are stable for the relevant packages. Package-by-package release can allow fabrication, logistics booking and site work to progress in parallel without waiting for full project freeze.

What can delay delivery or installation?

Customs and logistics issues are separate from site readiness, utilities and installation constraints. Customs delays, incomplete site, unavailable utilities, interface problems, post-freeze changes, FAT or SAT problems and commissioning deficiencies can all affect delivery or installation.

How can buyers get a reliable schedule?

Require a milestone-based schedule that matches start and end milestones across suppliers, names owner dependencies, lists long-lead items, states shipping assumptions, identifies controlling activities, and shows how updates and recovery plans are handled.

Treat Lead Time as a Project Schedule, Not a Single Number

Modular cleanroom interior illustrating a completed installation
A modular cleanroom interior; the image is illustrative and does not imply a standard project duration.

There is no universal modular cleanroom lead time. Total completion depends on agreed start and end milestones, design freeze, manufacturing, site readiness, shipping, installation, integration, commissioning, classification testing and qualification where applicable. Stages may overlap, but the critical path controls completion. Compare supplier milestones using the same scope, dependencies, and start and end endpoints, and treat every date as an assumption to verify rather than a single number to accept.

Deiiang Cleanroom


References and sources checked: September 2026.

  • ISO 14644-4:2022, Cleanrooms and associated controlled environments — Part 4: Design, construction and start-up. https://www.iso.org/standard/72379.html
  • iso 14644-1:2015, Cleanrooms and associated controlled environments — Part 1: Classification of air cleanliness by particle concentration. https://www.iso.org/standard/53394.html
  • ISO 14644-3:2019, Cleanrooms and associated controlled environments — Part 3: Test methods. https://committee.iso.org/standard/60598.html?browse=ics
  • NIH ORF, Modular Construction for Cleanroom Facilities, February 2022. This NIH research-facility publication discusses modular construction, factory utility limitations, tight clearances and SAT implications in its specific context. It is not a general industry standard. https://orf.od.nih.gov/TechnicalResources/Documents/News%20to%20Use%20PDF%20Files/2022%20NTU/Modular%20Construction%20for%20Cleanroom%20Facilities-February%202022%20News%20to%20Use_508.pdf
  • Deiiang Pharma Solutions, company-published planning source. This company-published material includes a 3–6 month pharmaceutical planning reference linked partly to parallel factory fabrication and site preparation. It is not independent industry data, not an industry average, not a guarantee and not a contractual commitment. https://www.cleanroomequips.com/uploads/pdf/Deiiang%E2%84%A2%20Pharma%20Solutions.pdf
  • Hubei Chunhui class 100 clean booth case, company-published case page. This is one company-published clean-booth on-site sequence, not a full project lead time and not the basis for the 3–6 month planning reference. https://www.cleanroomequips.com/case/3330.html

Cleanroom Insiders Expert Team

Deiiang's expert team specializes in designing and constructing state-of-the-art cleanrooms tailored to meet diverse industry needs. With a focus on innovation and compliance, we deliver pristine environments that ensure operational excellence and product integrity.

https://www.cleanroomequips.com/Modular-CleanRoom-FAQ/What-is-the-typical-lead-time-for-a-modular-clean-room-project-.html

Home

PHONE

Email

Inquiry
