How do modular cleanrooms work?
Modular panels create the enclosure, while engineered filtration, airflow/HVAC, pressure balance, utilities, monitoring, operating practices and installed-system testing create the controlled environment. Panels or HEPA filters alone do not establish ISO class or compliance. Performance depends on the integrated system and verification after installation.
What Makes a Modular Cleanroom a Controlled Environment?
Modularity is a construction method, not a cleanliness performance rating.

The enclosure creates the controlled boundary
Walls, ceiling, doors, glazing, joints, seals and penetrations limit uncontrolled air exchange.
Air treatment controls airborne particles
Filtered supply air circulates and returns or exhausts, diluting or removing particles generated by people, equipment or processes.
Pressure controls the direction of air movement
Pressure results from supply, return and exhaust balance plus leakage, doors, openings and adjacent spaces; positive or negative pressure is risk-based.
Controls and operating practices keep the system stable
Controls may use varied strategies, while sensors, alarms, cleaning, maintenance and personnel discipline affect ongoing performance.
Installed performance must be verified
Testing verifies defined attributes; ISO classification is measured airborne particle concentration under specified conditions [1].
| System element | Function | Does not prove | Buyer verification |
|---|---|---|---|
| Enclosure | Contains controlled volume | ISO class or compliance | Supplier specifies panels, joints and seals; drawings submitted; installer assembles; acceptance by inspection |
| Filtration | Removes airborne particles from supply air | Room classification | Supplier specifies filter class and test basis; product data submitted; installer seals filters; acceptance by integrity testing where specified |
| Airflow/HVAC | Distributes filtered air; manages temperature and humidity | Universal ACH or ffu rule | Supplier specifies design basis and recirculation effects; calculations submitted; installer commissions; acceptance against project criteria |
| Pressure control | Guides air movement between spaces | Universal positive-pressure rule | Supplier specifies balance, leakage and adjacency assumptions; design submitted; installer balances; acceptance by pressure verification |
| Controls/monitoring | Operates systems; records trends and alarms | Formal classification | Supplier specifies sensors, alarms and logging; calibration certificates submitted; integrator tests controls; acceptance by alarm and data review |
| Operating practices | Maintains stable conditions | Equipment capability | Supplier provides cleaning and maintenance procedures; operator complies; acceptance by procedure review and training records |
| Installed-system testing | Verifies defined attributes | Anything beyond tested scope | Tester specifies methods; reports submitted; testing body responsible; acceptance by review against project criteria |
Enclosure
Function: Contains controlled volume.
Does not prove: ISO class or compliance.
Buyer verification: Supplier specifies panels, joints and seals; drawings submitted; installer assembles; acceptance by inspection.
Filtration
Function: Removes airborne particles from supply air.
Does not prove: Room classification.
Buyer verification: Supplier specifies filter class and test basis; product data submitted; installer seals; acceptance by integrity testing where specified.
Airflow/HVAC
Function: Distributes filtered air; manages temperature and humidity.
Does not prove: Universal ACH or FFU rule.
Buyer verification: Supplier specifies design basis and recirculation effects; calculations submitted; installer commissions; acceptance against project criteria.
Pressure control
Function: Guides air movement between spaces.
Does not prove: Universal positive-pressure rule.
Buyer verification: Supplier specifies balance, leakage and adjacency assumptions; design submitted; installer balances; acceptance by pressure verification.
Controls/monitoring
Function: Operates systems; records trends and alarms.
Does not prove: Formal classification.
Buyer verification: Supplier specifies sensors, alarms and logging; certificates submitted; integrator tests; acceptance by alarm and data review.
Operating practices
Function: Maintains stable conditions.
Does not prove: Equipment capability.
Buyer verification: Supplier provides procedures; operator complies; acceptance by procedure review and training records.
Installed-system testing
Function: Verifies defined attributes.
Does not prove: Anything beyond tested scope.
Buyer verification: Tester specifies methods; reports submitted; testing body responsible; acceptance by review against project criteria.
How the Modular Enclosure and Panels Work
Panels create maintainable boundaries, and materials or joints do not assign ISO class.

Wall and ceiling panels
Wall and ceiling panels form the enclosure with cleanable surfaces and structural capacity for specified ceiling equipment.
Panel core versus exposed surface
The core affects structure, thermal and fire behavior, while the facing affects cleanability and chemical resistance.
Doors, windows and room openings
Doors and glazing provide access and visibility, while pass-throughs and equipment openings require pressure and cleanliness coordination.
Joints, seals and corners
Joints, seals and corners control leakage and cleanability, so they require inspection and maintenance.
Utility and duct penetrations
Electrical, gas, water, drain and duct penetrations must be coordinated before fabrication to preserve sealing.
Modular does not automatically mean portable
Relocatability depends on enclosure, HVAC and utilities, and classification is not preserved automatically after relocation.

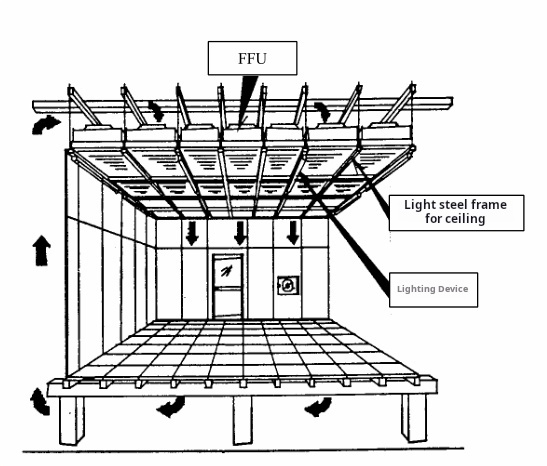

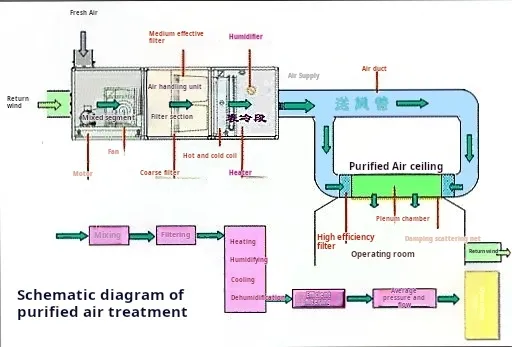

How Airflow and HEPA Filtration Work
Airflow follows supply, distribution, dilution or removal, then return or exhaust; no universal ACH or FFU rule applies.

Supply air and recirculation
Supply quantity follows heat load, particle generation, recovery needs and occupancy, while recirculation effects are design-specific.
HEPA and ULPA filtration
HEPA and ULPA filters are specified by class, efficiency and test basis, with airflow and pressure drop from product data.
A filter rating does not prove room classification
Filter efficiency describes the filter, not the room; ISO classification is measured airborne particles under specified conditions [1].
Unidirectional and non-unidirectional airflow
Unidirectional or non-unidirectional airflow is selected by process and contamination need, with iso 14644-3 supporting applicable tests [3].
Return-air paths and contamination removal
Return paths must coordinate with supply, equipment layout and occupants to avoid stagnant zones or disrupted patterns.
Localized clean zones
Localized clean zones may provide higher control where the process requires it, but no generic rule applies.
How Pressure and Air Balance Work
Pressure difference is an airflow-balance result involving supply, return, exhaust, leakage, doors, openings and adjacent spaces.

Positive-pressure applications
Positive pressure may protect a cleaner space, but the choice is risk-based and follows the contamination-control strategy.
Negative-pressure or containment applications
Negative pressure may support containment, but negative pressure alone is not containment and other controls may be required.
Pressure cascades between rooms
Pressure cascades and airlocks may be justified where adjacent spaces or transitions require defined relationships.
Doors, leakage and transient conditions
Door openings, penetrations and leakage affect pressure stability, so design and procedures must account for these events.
Monitoring pressure relationships
Pressure sensors and alarms may be required where critical, following application and risk assessment rather than a universal value.
How HVAC and Utilities Support the Cleanroom
HVAC and enclosure are separate but interdependent scopes whose interfaces must be clarified early.

Heating and cooling
HVAC capacity must address heat loads from people, process equipment and external conditions to maintain specified conditions.
Humidity control
Humidity control may be required for process, ESD, condensation or comfort reasons and is not ISO-driven.
Make-up air, exhaust and recirculation
Make-up air replaces exhaust and exfiltration, exhaust removes contaminants or heat, and recirculation effects are design-specific and balanced with exhaust and process needs.
Process exhaust
Process exhaust follows hazard assessment and applicable safety requirements and applies only where the process generates relevant contaminants.
Electrical and process utilities
Power, data, gases, water and drainage must be coordinated with the enclosure, since utility locations affect panel design and access.
Host-building interfaces
Structural capacity, HVAC capacity, fire and building constraints and maintenance access affect modular installation.
How Controls and Monitoring Work
Controls operate systems and monitoring provides evidence, but continuous particle monitoring is not universal.

HVAC and FFU controls
Controls may use varied strategies for start/stop, fan speed, grouping and setpoints, affecting energy use and stability.
Environmental sensors
Pressure, temperature, relative humidity and process-specific sensors provide data whose usefulness depends on selection and placement.
Particle monitoring
Particle monitoring differs from classification because iso 14644-1 classification verifies a state [1], while iso 14644-2 uses risk-based monitoring [2].
Alarms and data logging
Alarms alert operators to excursions, and data logging supports trend review, with limits and escalation defined in advance.
Monitoring does not replace testing
Trend monitoring is not formal classification or commissioning and does not establish compliance by itself.
How People and Materials Move Through the Cleanroom
People, material and equipment movement can generate contamination, so layout and procedures affect contamination control.

Personnel entry and gowning
Entry sequence and gowning requirements follow the process and cleanliness sector, supported by training and assessment.
Material transfer
Pass-throughs, airlocks or procedures may be used for material transfer depending on cleanliness strategy and risk.
Equipment movement and maintenance
Equipment openings and service routes affect control, and maintenance may require additional precautions.
Clean-to-controlled progression
Routes follow project contamination-control, zoning and pressure strategy; no universal personnel or material flow direction applies.
Operational discipline
Doors, cleaning, transfer procedures and training affect ongoing performance, so procedures should be clear and followed consistently.
How Modular Cleanroom Installation Works
Installation follows a project-specific sequence, and no universal install or testing sequence or fixed duration applies to all projects.

Pre-installation site review
Site review addresses dimensions, levelness, structure, utilities, access, ceiling height and applicable codes.
Layout and enclosure assembly
Walls, ceiling, doors, glazing, joints and openings are assembled according to design, with inspection supporting quality.
HVAC and filtration installation
FFUs, terminals, ducts, returns and exhaust are installed, and enclosure interfaces must be coordinated.
Utilities and controls integration
Power, sensors, data/BMS and process services are connected, with commissioning following installation.
Sealing and construction cleaning
Sealing and construction cleaning occur before testing, and inspection identifies incomplete sealing or contamination.
Installation sequence dependencies
Panel completion does not mean operational room; HVAC, utilities, controls and testing must be completed, with sequence depending on project conditions.
Process diagram in text: Design freeze → Site prep → Enclosure → HVAC/filters → Utilities/controls → Sealing/cleaning → Balancing → Testing → Handover.
How Commissioning and Testing Confirm Performance
Commissioning, classification and qualification are distinct, and testing shows only defined attributes under defined conditions.

Air balance and pressure verification
Air balance and pressure relationships are verified against project criteria before classification where classification is required.
Filter integrity and airflow tests
Filter integrity and airflow tests use applicable methods such as ISO 14644-3 where specified [3].
Particle classification
Particle classification uses ISO 14644-1 airborne-particle classification [1] and is distinct from commissioning and qualification.
Occupancy state must be specified
Classification may be as-built, at-rest or operational, and not all states are automatically required.
Controls and alarm testing
Sensors, alarms and interlocks are tested where applicable, with records documenting process and results.
Commissioning versus qualification
Commissioning verifies that systems function, while qualification may be required in regulated sectors with additional documentation.
Handover records
Handover records may include drawings, balance and test reports, calibration records, manuals, spares and training materials.
How modular cleanrooms Stay Controlled During Operation
Performance depends on operation, cleaning, maintenance and change control, not design and installation alone.

Cleaning programme
Approved surfaces, agents and methods should be specified, defined and followed.
Filter and HVAC maintenance
Filter and HVAC maintenance follows manufacturer recommendations and system design, with no universal replacement interval.
Sensor calibration and monitoring review
Sensors should be calibrated on a planned schedule, and monitoring data should be reviewed for trends.
Door, seal and enclosure inspection
Doors, seals and enclosure surfaces should be inspected for damage, and penetrations should remain sealed.
Change control
Changes may require engineering review and retesting, with significance assessed through change control.
Operations control programme
iso 14644-5:2025 addresses operations control programme requirements [5], covering policies, procedures, training, entry and exit, cleaning, maintenance and monitoring.
What a Modular Cleanroom Cannot Do by Itself
Correcting common misconceptions helps buyers set realistic expectations.

Panels do not create an ISO class
Panels form the enclosure, while ISO class is measured airborne particles under specified conditions [1].
More FFUs do not automatically mean a cleaner room
FFU quantity is a design choice, and room cleanliness depends on the complete system and contamination sources.
HEPA filtration does not establish sterility
HEPA filtration removes airborne particles but does not sterilize surfaces, and a HEPA rating is not room classification.
Positive pressure is not universally correct
Positive pressure protects some spaces while negative pressure supports containment in others, and negative pressure alone is not containment.
Modular construction does not automatically provide regulatory compliance
Modular construction is a building method, and compliance depends on meeting applicable regulatory requirements where relevant.
Relocatability does not preserve classification
Classification after relocation requires re-verification and does not transfer automatically.
Standards and Regulatory Boundaries
ISO standards provide classification, design, testing and operations frameworks, while sector regulations apply only where relevant.

iso 14644-1:2015
ISO 14644-1:2015 addresses particle classification by airborne particle concentration under specified conditions [1].
ISO 14644-2:2015
ISO 14644-2:2015 addresses monitoring using a risk-based approach to provide evidence of continued performance [2].
iso 14644-3:2019
ISO 14644-3:2019 provides supporting test methods used to verify defined performance attributes [3].
iso 14644-4:2022
ISO 14644-4:2022 covers design, construction and start-up from requirements through commissioning and handover [4].
iso 14644-5:2025
ISO 14644-5:2025 addresses operations and specifies requirements for an operations control programme [5].
United States — sterile drug/biological aseptic processing only
FDA 2004 guidance is nonbinding and applies only within the applicable CGMP aseptic-processing scope for sterile drug and biological products [6].
EU / EEA — sterile medicinal-product manufacturing only
EU GMP Annex 1 applies only within the applicable sterile GMP scope for sterile medicinal products [7].
Other sectors and regions
Other sectors and regions may have different requirements, so the actual regulation, customer requirements and authority having jurisdiction should be identified.
Deiiang Company-Published Product Information and Evidence Boundary
Company pages can support Deiiang product-option statements only, not independent performance proof.

Publicly described modular system
Deiiang’s modular clean room page describes modular cleanrooms and states that the structure supports disassembly, reassembly and relocation, per company-published information [8].
Public filtration and control options
Deiiang’s Clean Booth page lists HEPA and ULPA filter options and a group control system for FFUs, per company-published information [9].
Claims not to import
Generic ACH, pressure, compliance, energy, price, speed or performance claims should not be treated as neutral facts.
Project evidence boundary
Project cases, test data, photos, schedules, prices or measured outcomes should not be invented.
What Buyers Should Specify Before Requesting a Quote
Dimensions and ISO class alone are insufficient, so additional requirements must be defined for meaningful comparison.

Process and contamination-control basis
Define contamination sources and control needs, since the basis drives system design.
Cleanliness and test basis
Specify cleanliness level, test basis, occupancy state, test methods and acceptance criteria.
HVAC and pressure requirements
Specify HVAC capacity, temperature, humidity and pressure relationships between spaces.
Enclosure and access
Define enclosure specifications, access requirements, openings, doors, pass-throughs and maintenance access.
Utilities and controls
Specify utility requirements, control and monitoring needs, integration requirements, and sensor and alarm requirements.
Installation and site information
Document site conditions, access and constraints, and clarify installation responsibilities.
Testing and documentation
Specify testing scope, acceptance criteria, documentation and handover records.
Commercial scope
Define scope boundaries, exclusions and responsibilities to support fair comparison.
Modular Cleanroom Procurement Comparison Table
Normalize scope and responsibility rather than headline price.

Desktop comparison table
| Requirement | Supplier proposal | Evidence/document | Responsibility | Clarification needed |
|---|---|---|---|---|
| Enclosure | Specify panels, joints, seals, openings, finish | Drawings, panel data | Supplier design; installer assembly | Cleanability, leakage assumptions, access |
| Filtration | Specify filter class, efficiency, test basis | Product data, certificates | Supplier supply; installer sealing | Integrity method, acceptance criteria |
| HVAC | Specify capacity, airflow design, recirculation | Calculations, equipment data | Supplier design; installer commissioning | Design basis, recirculation effects |
| Return/exhaust | Specify return paths, exhaust needs, balance | Layouts, balance report | Supplier design; installer balancing | Equipment and adjacency coordination |
| Pressure | Specify relationships, leakage, door effects | Pressure design, balance records | Supplier design; installer balancing | Adjacency assumptions, acceptance values |
| Temperature/RH | Specify setpoints, tolerances, control method | HVAC data, control sequence | Supplier design; installer controls | Process needs, test conditions |
| Utilities | Specify power, data, gas, water, drain interfaces | Utility drawings, schedules | Supplier coordination; installer connection | Interface responsibilities |
| Monitoring | Specify sensors, alarms, logging, review | Sensor data, calibration certificates | Supplier supply; integrator testing | Alarm limits, escalation, retention |
| Installation | Specify scope, sequence, site requirements | Installation plan, method statements | Agreed supplier/installer split | Access, dependencies, constraints |
| Balancing | Specify scope and acceptance criteria | Balance report, measurements | Installer or specialist | Separate from classification |
| Classification | Specify basis and occupancy state | ISO 14644-1 report [1] | Testing body for defined tests | Locations, states, criteria |
| Tests | Specify methods and pass/fail criteria | Test reports, certificates | Testing body for defined tests | Attributes each test verifies |
| Training | Specify scope and materials | Training records, manuals | Supplier delivery; operator attendance | Operational and maintenance topics |
| Warranty | Specify scope, period, exclusions | Warranty terms | Supplier by agreed terms | Response, spares, exclusions |
| Exclusions | List all exclusions and assumptions | Written exclusion list | Agreed split | No critical scope omitted |
Mobile card alternative
Enclosure
Supplier proposal: Specify panels, joints, seals, openings, finish.
Evidence/document: Drawings, panel data.
Responsibility: Supplier design; installer assembly.
Clarification needed: Cleanability, leakage assumptions, access.
Filtration
Supplier proposal: Specify filter class, efficiency, test basis.
Evidence/document: Product data, certificates.
Responsibility: Supplier supply; installer sealing.
Clarification needed: Integrity method, acceptance criteria.
HVAC
Supplier proposal: Specify capacity, airflow design, recirculation.
Evidence/document: Calculations, equipment data.
Responsibility: Supplier design; installer commissioning.
Clarification needed: Design basis, recirculation effects.
Return/exhaust
Supplier proposal: Specify return paths, exhaust needs, balance.
Evidence/document: Layouts, balance report.
Responsibility: Supplier design; installer balancing.
Clarification needed: Equipment and adjacency coordination.
Pressure
Supplier proposal: Specify relationships, leakage, door effects.
Evidence/document: Pressure design, balance records.
Responsibility: Supplier design; installer balancing.
Clarification needed: Adjacency assumptions, acceptance values.
Temperature/RH
Supplier proposal: Specify setpoints, tolerances, control method.
Evidence/document: HVAC data, control sequence.
Responsibility: Supplier design; installer controls.
Clarification needed: Process needs, test conditions.
Utilities
Supplier proposal: Specify power, data, gas, water, drain interfaces.
Evidence/document: Utility drawings, schedules.
Responsibility: Supplier coordination; installer connection.
Clarification needed: Interface responsibilities.
Monitoring
Supplier proposal: Specify sensors, alarms, logging, review.
Evidence/document: Sensor data, calibration certificates.
Responsibility: Supplier supply; integrator testing.
Clarification needed: Alarm limits, escalation, retention.
Installation
Supplier proposal: Specify scope, sequence, site requirements.
Evidence/document: Installation plan, method statements.
Responsibility: Agreed supplier/installer split.
Clarification needed: Access, dependencies, constraints.
Balancing
Supplier proposal: Specify scope and acceptance criteria.
Evidence/document: Balance report, measurements.
Responsibility: Installer or specialist.
Clarification needed: Separate from classification.
Classification
Supplier proposal: Specify basis and occupancy state.
Evidence/document: ISO 14644-1 report [1].
Responsibility: Testing body for defined tests.
Clarification needed: Locations, states, criteria.
Tests
Supplier proposal: Specify methods and pass/fail criteria.
Evidence/document: Test reports, certificates.
Responsibility: Testing body for defined tests.
Clarification needed: Attributes each test verifies.
Training
Supplier proposal: Specify scope and materials.
Evidence/document: Training records, manuals.
Responsibility: Supplier delivery; operator attendance.
Clarification needed: Operational and maintenance topics.
Warranty
Supplier proposal: Specify scope, period, exclusions.
Evidence/document: Warranty terms.
Responsibility: Supplier by agreed terms.
Clarification needed: Response, spares, exclusions.
Exclusions
Supplier proposal: List all exclusions and assumptions.
Evidence/document: Written exclusion list.
Responsibility: Agreed split.
Clarification needed: No critical scope omitted.
No calculator recommendation
No generic ACH, FFU or pressure calculator is recommended because design depends on the specific process, layout and requirements.
Final Buyer Checklist
A compact checklist for RFQ and pre-order verification.

Performance
Define cleanliness level, test basis, acceptance criteria, temperature, humidity, pressure and occupancy state.
System interfaces
Identify HVAC, utility and control interfaces, clarify scope boundaries and document site conditions.
Operation
Define cleaning, maintenance and monitoring requirements, specify training and documentation needs, and address change control.
Handover
Define handover documentation, test reports, drawings, manuals, calibration records, warranty and support terms.
FAQs
Answers remain project-specific; verify requirements for the actual application.
How does a modular cleanroom work?
Modular panels create the enclosure, while filtration, airflow, pressure control, utilities, monitoring and operating practices maintain controlled conditions verified by testing.
What controls the cleanliness level inside a modular cleanroom?
Filtration, airflow, enclosure integrity, contamination sources and operating practices all affect cleanliness, and ISO class is measured particles under specified conditions [1].
Do modular cleanrooms always use HEPA filters?
HEPA filtration is common where particle control is required, but configuration depends on the application and a HEPA rating is not room classification.
How is pressure controlled in a modular cleanroom?
Pressure results from supply, return and exhaust balance, leakage, doors, openings and adjacent spaces, with sensors and controls maintaining setpoints.
What should buyers verify before purchasing a modular cleanroom?
Verify scope, performance requirements, test basis, documentation, responsibilities and exclusions, and define acceptance criteria before purchase.
Conclusion — The Whole System Creates the Controlled Environment
A modular cleanroom works as an integrated system: the enclosure contains the volume, filtration and airflow remove particles, pressure guides air movement, and controls and procedures maintain stability. Installed-system testing verifies performance. Panels or filters alone do not establish ISO class or compliance, so buyers should define process requirements and acceptance criteria before specifying a system.

References
- ISO 14644-1:2015, Cleanrooms and associated controlled environments — Part 1: Classification of air cleanliness by particle concentration. https://www.iso.org/standard/53394.html
- ISO 14644-2:2015, Cleanrooms and associated controlled environments — Part 2: Monitoring to provide evidence of cleanroom performance related to air cleanliness by particle concentration. https://www.iso.org/standard/53393.html
- ISO 14644-3:2019, Cleanrooms and associated controlled environments — Part 3: Test methods. https://www.iso.org/standard/60598.html
- iso 14644-4:2022, Cleanrooms and associated controlled environments — Part 4: Design, construction and start-up. https://www.iso.org/standard/72379.html
- ISO 14644-5:2025, Cleanrooms and associated controlled environments — Part 5: Operations. https://www.iso.org/standard/88599.html
- U.S. Food and Drug Administration, Sterile Drug Products Produced by Aseptic Processing — Current Good Manufacturing Practice (2004, nonbinding guidance). https://www.fda.gov/regulatory-information/search-fda-guidance-documents/sterile-drug-products-produced-aseptic-processing-current-good-manufacturing-practice
- European Commission, EU Guidelines for Good Manufacturing Practice, Annex
- European Commission, EU Guidelines for Good Manufacturing Practice, Annex 1: Manufacture of Sterile Medicinal Products (2022). https://health.ec.europa.eu/document/download/e05af55b-38e9-42bf-8495-194bbf0b9262_en?filename=20220825_gmp-an1_en_0.pdf
- Deiiang, Modular Clean Room (company-published). https://www.cleanroomequips.com/Modular-Clean-Room/
- Deiiang, Clean Booth (company-published). https://www.cleanroomequips.com/CleanBooth/
MENU
